|
Using
Spreadsheets to Optimally Unbalance a Construction Bid
|
|
Spreadsheets’
use in construction is increasing due to their robustness and
versatility in automating a number of everyday tasks in the construction
industry. A number of
spreadsheet applications have been suggested to accomplish a wide array
of tasks including developing estimates quickly and accurately,
summarizing costs, presenting cost estimates details, analyzing and
controlling costs as well as data validation. This paper presents
another useful use of spreadsheets to optimally unbalance construction
bid prices. Unbalancing the bid is defined
here as bidding the cost items that are completed earlier on in the
project higher than the original marked up bid (i.e. balanced bid),
while bidding the items that are completed later on in the project lower
than the original balanced bid. The proposed spreadsheet
formulation can be used in real life as well as in teaching students
about bid unbalancing. The model can be used by professionals to
increase the profitability of their projects. By varying the different
parameters in the model such as the interest rate and the construction
schedule, students can examine the effect of all these variables on the
total project’s revenues. Key Words: bid unbalancing, optimization, spreadsheet applications, linear programming, cost analysis, present value |
|
Introduction
Many
contractors have spreadsheet program on their computer and their use in
construction cost estimating, cost analysis and control is increasing
(Carmichael 1997). While the possibilities for automating and customizing
spreadsheets are unlimited, they are mostly used to set up basic cost breakdown
summary sheets with basic formulas (Christofferson 2000). Christofferson (1999)
presented some helpful methods that convert basic spreadsheets into useful tools
to accomplish estimates quickly and accurately including setting up a summary
sheet, creating detail sheets, information lookup methods for estimating and,
data validation. This paper presents another useful use of spreadsheets to
optimally unbalance the unit prices on a construction bid. The proposed
spreadsheet application can be used by contractors in real life situations to
help in unbalancing their bids to maximize profits, as well as in a classroom
setting to teach construction students about the effects of bid unbalancing on
the profit. The remainder of this paper is organized as follows: bid unbalancing
is discussed in the next section. This is followed by a description of the
proposed spreadsheet model. The use of the spreadsheet model is demonstrated
through a simple example and the results are discussed. Finally, the conclusions
and recommendations for future developments are presented.
Bid
Unbalancing
When
bidding a construction contract it is important to consider the timing of
progress payments as well as the amount of the bid itself. The progress payment
schedule is directly related to the construction schedule since they are made
based on the actual work completed, less some holdback (or retainage). In most
cases, this results in the contractor incurring financing charges on the
negative cash flow for most of the project duration. Progress payment therefore
will have a significant impact on the amount of profit made. This is clear when
the time value of money is considered and the present worth of the progress
payment received is considered instead of just the cumulative sum of the
payments.
One
of the methods that the finance charges on the negative cash flow can be
decreases, and thus increasing the profit, is by unbalancing the bid. A balanced
bid is one where the actual costs and markups are accurately assigned to the
appropriate bid items for unit price contracts. Unbalancing the bid means
bidding the cost items that are completed earlier on in the project higher than
the original marked up bid (i.e. balanced bid), while bidding the items that are
completed later on in the project lower than the original balanced bid. This is
done while maintaining the same total price unchanged. This is sometimes
referred to as Front Loading the project.
Front
loading is widely practiced on unit price contracts. In
unit price contracts, the bidders usually provide a cost per unit for each line
item on the bid form. The total bid amount is summed up and the contract is
awarded based on the total combined bid. Unit price contracts are very common in
heavy construction such as highway reconstruction and rehabilitation projects.
Owners often use this type of contract when the exact scope and quantities of
the work to be performed cannot be accurately determined. This shifts the risk
to the contractor because of the inability to determine the exact quantities
ahead of time, since the quantities on the bid forms are not always accurate.
This is why most contracts include a renegotiation clause when the actual
quantities differ significantly from those on the bid forms. A contract clause
for example can read:
“Should
the total as-built quantity of any major pay item required under the contract
exceed the estimate contained in the proposal therefore by more than twenty five
percent, the work in excess of the one hundred and twenty five percent will be
paid for by adjusting the unit price…
(Hinze, 2001)”
On
the other hand, when the contractor knows from experience that there is a line
item that a particular owner usually furnishes himself and therefore has a high
probability of being eliminated from the contract, the contractor would deflate
the cost of this line item and inflate a cost of another earlier on in the
project. It is important to note therefore that the
risk increases tremendously if the contractor decides to front load the project
by unbalancing the bid, especially if the actual quantities differ from the
quantities on the bid form within the limit specified in the contract and the
contractor is not allowed to renegotiate the bid price. The contractor stands to
loose a significant amount of money if he/she unbalances the bid and then it
turns out that the quantities of those line items that he/she has inflated to
front load the project, are actually less than the amount on the bid form.
Unbalancing
can also occur on the schedule of values that the contractor is required to
submit in lump sum bids. The owner uses to this schedule of values to determine
progress payments to the contractor. The contractor would sometimes unbalance
this schedule of values to front load the project. By unbalancing or
front-loading the project, the contractor is in essence trying to get the
majority of her/her money at the earliest possible time. The contractor might
for example inflate the mobilization cost on the schedule of values and deflate
the cost of another item later on in the project. In other words, the contractor
is trying to increase the present worth of the payments from the owner. The
present worth takes into account when the payment is made, by considering the
time value of money. Therefore, the objective of bid unbalancing is to maximize
the present worth of the payments by changing the bid prices for the different
items within acceptable limits and at the same time keeping the bid price equal
to that of the balanced bid (i.e. the bid before unbalancing). In the next
section, the problem of maximizing the present worth of the progress payments is
presented.
Problem
Formulation
Bid
unbalancing have been addressed before in the literature (Ahuja and Campbell
1988, Stark and 1972). When there is a high degree of certainty regarding the
quantities furnished by the owner in the bid form for a unit price contract or
regarding the quantities and line items on a schedule of values, the bid
unbalancing problem can be formulated and solved as a linear programming
problem. Previous formulations of this problem, such as those in (Ostwald 2001,
Taha 2001), consider maximizing the present worth of the progress payments
received by the contractor. Mathematically this is expressed as:
|
When
unbalancing the bid there are two constraints that should be addressed. Firstly,
there is a constraint on the bid prices for the different line items themselves.
Although most owners will accept unbalancing to some extent, the owner can
disqualify a bid on the basis of obvious unbalancing [Hinze 2001]. The
instructions to bidders in most contracts include a clause that “if the bid
prices are obviously unbalanced, the owner has the option to reject the
submitted bid….”. The contractor needs to establish reasonable upper and
lower limits on his bid prices, so that the bid does not get rejected. This is
expressed as:
|
In
addition the present value of the progress payments cannot exceed the bid amount
in order to maintain the competitiveness of the bid. This can be expressed as:
|
The
linear programming problem formulated above can be solved manually using the
simplex method. However, an easier approach would be to model and solve the
problem using any commercial spreadsheet. In the next the proposed spreadsheet
solution is presented.
Problem
Solution
Spreadsheets
provide a transparent way of modeling the problem, giving the user a complete
understanding and control of the different variables and constraints in the
problem. For the majority of construction problems, whose size usually ranges
from small to medium, spreadsheet solutions are the most efficient and
economical method to solve the problem. Excel provides a solver add-in, which
can be used for optimizing such problems. In order to demonstrate the proposed
spreadsheet model, consider the simple project shown in Figure 1. The problem
presented here is adopted from (Ahuja and Campbell 1988). The project consists
of 4 main activities. The main objective is to determine the unit prices to
assign to each activity in order to maximize the present value. The proposed
solution to this model involves a 4-step process.
Step
One: Enter all the Required Data
The
first step is to enter all the required data into the spreadsheet. As shown in
figure 2, the first and most important variable to consider it the monthly
interest rate that will be used. Here, a contractor could use the interest rate
that he/she expects to make on his/her money if the money was to sit in the
bank. Secondly the upper and lower limits on the bid price have to be set. These
values can be set from experience. Alternatively, a contractor could use the
maximum fluctuation in the bid price before the bid can be disqualified as
specified in the contract. The quantities and the scheduled completion values
for the different activities can be determined from the actual project’s
construction documents.
|
Figure
1: The
Gantt Chart for the Example Project |
Table
1
The
Example Project with Monthly Interest Rate at 1%
|
Original
Bid |
lower
Limit |
upper
Limit |
Quantities |
Scheduled
Completion (months) |
Bid
Price ($) |
Bid
Amount ($) |
Present
Value ($) |
Clearing |
2 |
1.6 |
3.8 |
25000 |
6 |
2 |
$
50,000.00 |
($47,102.26) |
Earth
Excavation |
6 |
4 |
9 |
50000 |
12 |
6 |
$
300,000.00 |
($266,234.77) |
Rock
Excavation |
12 |
10 |
15 |
50000 |
15 |
12 |
$
600,000.00 |
($516,809.68) |
Paving |
10 |
6 |
16 |
25000 |
24 |
10 |
$
250,000.00 |
($196,891.53) |
Bid
Amount has to be the same = |
$1,200,000
|
|||||||
Maximize
Present Value of Costs = |
($1,027,038) |
![]() |

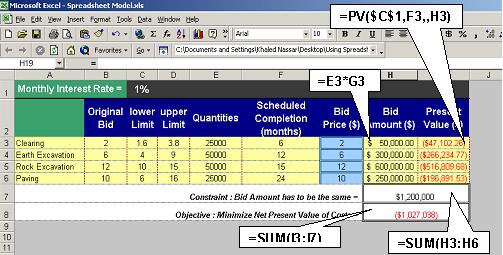

Figure 2: The Formulas Used in the Model |
Step
Two: Calculate the Present Value of the incomes
Once
all the data has been entered the present value has to be calculated. In excel,
the PV() function can be used to determine the present value of the progress
payment for each of the activities in the project as shown in Figure 2. The
present value function uses the bid amount (which is the quantity multiplied by
the bid price), the scheduled completion time (or the time actual time that the
payment is expected to be made), as well as the interest rate used. One can see
that the proposed formulas are fairly straightforward and therefore can be
easily utilized by contractors and understood by students. As formula (1) above
suggests, the present value for the total project is simply the sum of all the
present values of the different activities.
|

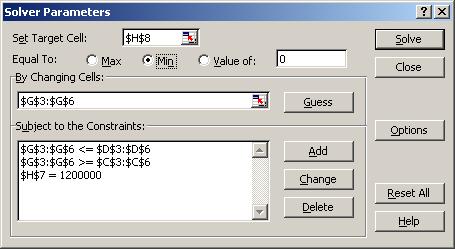

Figure
3: Solver
Parameters for the Model |
Step
Three: Setup the solver variable, constrains, and objective
In
order to solve this problem using the spreadsheet formulation we need to use the
excel Solver Add-in. The Solver Add-in can be used to optimize a wide range of
problems and is very robust and efficient in solving linear programming problems
such as the one at hand. Therefore, the third step is to run the excel solver
and maximize the present value of the progress payments. Figure 3 shows the
parameters used in the model. The changing cells (or the problem variables) as
well as the constraints as defined in the solver parameter dialog box. In
addition to the traditional excel solver, there are a wide array of other
commercial optimization add-ins available to handle larger problems. For
example, the genetic algorithm solver add-in works with existing Excel Solver
models to solve much larger problems up to hundreds of times faster.
Step
Four: Run optimization and analyze the results
The
last step is to run the solver add-in and generate the different solution
reports. Table 3, shows solver answers report. Important information about the
model can be extracted from this report. For example, it can be seen that by
changing the bid prices from their initial balanced values (the “Original
Value” column) to the new unbalanced values (the “Final Value” column), an
increase of about $15,000 in the present value is possible ($1,041,963 –
$1,027,038). This means that the contractor can make $15,000 more by the new
cash flow. In order to achieve this increase in this simple example, once can
see that the clearing and the earth excavation bid prices have been inflated to
the their upper limit while a tradeoff in the rock excavation and paving bid
prices has been reached. In addition, figure 4 shows how the interest rate
affects the present worth of the payments. Expectedly, an increase in present
worth can be achieved with a higher interest rate.
Table
3
Answer
Report Generated by Solver
Target Cell
(Min) |
|
|||||
|
Cell |
Name |
Original
Value |
Final
Value |
||
|
$H$8 |
Present Value
($) |
($1,027,038) |
($1,041,963) |
||
|
||||||
Adjustable
Cells |
||||||
|
Cell |
Name |
Original
Value |
Final
Value |
||
|
$G$3 |
Clearing Bid
Price ($) |
2 |
3.8 |
||
|
$G$4 |
Earth
Excavation Bid Price ($) |
6 |
9 |
||
|
$G$5 |
Rock Excavation
Bid Price ($) |
12 |
10.1 |
||
|
$G$6 |
Paving Bid
Price ($) |
10 |
6 |
||
|
||||||
Constraints |
||||||
|
Cell |
Name |
Cell
Value |
Formula |
Status |
Slack |
|
$H$7 |
Bid Amount ($) |
$1,200,000
|
$H$7=1200000 |
Binding |
0 |
|
$G$3 |
Clearing Bid
Price ($) |
3.8 |
$G$3>=$C$3 |
Not
Binding |
2.2 |
|
$G$4 |
Earth
Excavation Bid Price ($) |
9 |
$G$4>=$C$4 |
Not
Binding |
5 |
|
$G$5 |
Rock Excavation
Bid Price ($) |
10.1 |
$G$5>=$C$5 |
Not
Binding |
0.1 |
|
$G$6 |
Paving Bid
Price ($) |
6 |
$G$6>=$C$6 |
Binding |
0 |
|
$G$3 |
Clearing Bid
Price ($) |
3.8 |
$G$3<=$D$3 |
Binding |
0 |
|
$G$4 |
Earth
Excavation Bid Price ($) |
9 |
$G$4<=$D$4 |
Binding |
0 |
|
$G$5 |
Rock Excavation
Bid Price ($) |
10.1 |
$G$5<=$D$5 |
Not
Binding |
4.9 |
|
$G$6 |
Paving Bid
Price ($) |
6 |
$G$6<=$D$6 |
Not
Binding |
10 |
|
Figure
4: Solver
Parameters for the Model |
Conclusion
and Recommendations for Future Research
This paper presented a useful application of spreadsheets to optimally unbalance the prices. By bidding the cost items that are completed earlier on in the project higher than the original marked up bid (i.e. balanced bid), while bidding the items that are completed later on in the project lower than the original balanced bid, the overall profitability of the project is increased. The optimum tradeoff between the bid prices was achieved using the developed spreadsheet model and the solver add-in. A number of future extensions are proposed for the developed model:
![]() | Addressing
the fact some contractors also unbalance their bids through manipulating
quantities. |
![]() |
The
fact that the quantities may change after the bid has been unbalanced. In
some cases there is great uncertainty about the quantities.
There is a possibility that
one or more line items will be canceled or that the owner will choose to
self perform some of the line items. In
other cases the contractor will be relatively sure that some items are going
to be deleted or added to the contract. |
![]() | Considering
the total cash flow, i.e. the contractor’s
expenditures as well as the incomes. A more accurate approach would
be to optimize the net present value resulting from the progress payment as
well as the contractor’s own expenditures. The contractor’s own expenses
would include his/her own cost to perform the work as well as other
associated costs like providing lien waivers for the different line items,
and other indirect costs. The goal of the optimization problem therefore
becomes to optimize the Net Present Value (NPV) for the project by changing
the bid prices. Alternatively one can consider optimizing
the bid in terms of the IRR instead of the present worth. Although the IRR
would give a more meaningful result, there is not close form solution for
calculating the IRR and therefore the problem may be harder to solve. |
![]() | Another
important issue to consider is the lien waiver amounts that have to be
provided by the contractor for the unbalanced bid items. |
![]() |
Incorporating
the schedule the retainage amount and the mobilization payment |
References
Ahuja,
H., Campbell, W., (1988) “Estimating From Concept to Completion,” Prentice
Hall Publishers, New Jersey
Stark,
R. M., and R. L. Nicholas, (1972) “Mathematical Foundations for design: Civil
Engineering systems,” McGraw Hill, New York
Philip
Ostwald, (2001) “Construction Cost Estimating and Analysis,” Prentice Hall
Publishers, New Jersey
Jimmie
Hinze, (2001) “Construction Contracts,” McGraw Hill Publishers, New
York
Hamdy
Taha, (2001) “Introduction to Operation Research, Prentice Hall
Publishers,” New Jersey
Christofferson,
Jay P. (1999) “ Using Powerful Spreadsheet Application Tools to Increase
the Efficiency and Effectiveness of Estimating”, ASC Proceedings of the
35th Annual Conference, California Polytechnic State University - San
Luis Obispo, California, April 7 - 10, 1999, pp 197 –204
Christofferson,
Jay P. (2000) “Estimating with Microsoft® Excel: Unlocking the Power for
Home Builders”, BuilderBooks Publishers
Carmichael,
J. (1997). 1997 Member Computer Study. Information Services Division,
National Association of Home Builders
